The Line, Not Just the Part

Every other blueprint on this site schedules a single build — one solar plant, one rocket, one research program. This one schedules a line: the tooling, machine qualification, pilot build, first article inspection, and volume ramp for the VR-40 Integrated Actuator, the rotary joint actuator that powers every arm, leg, and torso joint on Vantage Robotics’ Aegis humanoid platform. A humanoid robot needs 30 to 40 of these actuators per unit, and the actual scheduling problem is never “build one” — it is “stand up a repeatable process that can build them by the hundred without a first-pass yield collapse.”

That shape of problem — tooling, then a pilot batch, then a staffed-up steady-state line — is also why this blueprint uses a build technique none of the others do: a CSV/Excel import instead of a pasted tagged text block or an AI prompt sequence. A manufacturing engineering team standing up a new line almost always already has the task list somewhere — an ERP router, a program management spreadsheet, an MRP export — as a flat table of rows and columns, not as a hand-typed tag syntax. Two spreadsheets, imported in the right order, are what this schedule actually looks like before anyone opens Maverick.

The VR-40 itself is a compact case study in why this line needs four different engineering disciplines to agree on one schedule. Mechanical engineering owns the harmonic drive gearbox. Electromechanical engineering owns the BLDC motor and encoder. Controls and firmware engineering own the torque-control loop that makes the joint safe to put a hand near. Quality engineering owns the gate that decides whether any of it ships. This blueprint schedules all four in one line, one program, one pair of CSV files.

Cutaway diagram of the VR-40 integrated actuator showing encoder, motor, harmonic drive gearbox, and output flange

Program at a Glance

Before the first CSV is imported, here is the shape of what it builds: eight stations grouped into three ramp phases, running from tooling procurement in August 2030 through steady-state volume production in March 2031.

Timeline diagram showing eight production line stations grouped into tooling, pilot run, and volume ramp phases from August 2030 to March 2031

Skills by Discipline

What each engineering function on the line actually practices in this blueprint.

Discipline What You’ll Practice
Mechanical EngineeringHarmonic drive gearbox tooling, precision machining sequencing, and tolerance stack-up as scheduled work, not just drawings
Electromechanical EngineeringMotor and encoder subassembly builds converging into a single mating step via a Finish-to-Finish link
Controls and Firmware EngineeringTorque-loop bring-up scheduled to start before hardware integration finishes, using a Start-to-Start link with lag
Quality EngineeringFirst article inspection and burn-in as explicit schedule gates, not informal sign-offs
Program and Manufacturing ManagementBulk resource and task import, dependency verification, baseline, critical path, and resource-centric Gantt review across all 197 tasks

Station 1: Import the Resource Pool First

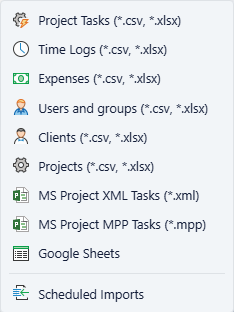

Go to File → Import → Users and groups. This is the single most important sequencing rule in this blueprint: import the Users CSV before the Project Tasks CSV. The task import assigns resources by name, and a name resolves only if the resource already exists — import tasks first and every Users cell in that file silently fails to assign.

File Import menu showing Project Tasks, Users and groups, and other importable record types

The Users CSV force-creates 40 resources under a nested workgroup tree — 12 Human, 14 Machine, and 14 Material — split across Engineering, Production, and Materials and Components. The Parent group column uses the same colon-delimited path convention as the workgroup paths used elsewhere on the site, so Actuator Line Program:Engineering:Controls and Firmware Engineering creates a three-level nested group in one row.

Workgroup tree diagram showing the Actuator Line Program's Engineering, Production, and Materials and Components branches with human, machine, and material resource counts
Name Parent group Resource type
Program ManagerActuator Line Program0
Mechanical Design EngineerActuator Line Program:Engineering:Mechanical Engineering0
Manufacturing EngineerActuator Line Program:Production0
Electromechanical EngineerActuator Line Program:Engineering:Electromechanical Engineering0
Controls EngineerActuator Line Program:Engineering:Controls and Firmware Engineering0
Firmware EngineerActuator Line Program:Engineering:Controls and Firmware Engineering0
Quality EngineerActuator Line Program:Engineering:Quality Engineering0
CNC MachinistActuator Line Program:Production:Machining Cell0
Assembly TechnicianActuator Line Program:Production:Assembly and Test Cell0
Test TechnicianActuator Line Program:Production:Assembly and Test Cell0
Supply Chain SpecialistActuator Line Program:Production0
Production Line SupervisorActuator Line Program:Production0
5-Axis CNC MillActuator Line Program:Production:Machining Cell2
CNC Gear Hobbing MachineActuator Line Program:Production:Machining Cell2
Wire EDM MachineActuator Line Program:Production:Machining Cell2
Precision Cylindrical GrinderActuator Line Program:Production:Machining Cell2
Heat-Treat FurnaceActuator Line Program:Production:Machining Cell2
Ultrasonic Cleaning SystemActuator Line Program:Production:Machining Cell2
Automated Stator Winding MachineActuator Line Program:Production:Assembly and Test Cell2
Robotic Pick-and-Place CellActuator Line Program:Production:Assembly and Test Cell2
Coordinate Measuring Machine (CMM)Actuator Line Program:Production:Assembly and Test Cell2
Torque Test StandActuator Line Program:Production:Assembly and Test Cell2
DynamometerActuator Line Program:Production:Assembly and Test Cell2
Encoder Calibration RigActuator Line Program:Production:Assembly and Test Cell2
Burn-In and Vibration Test RigActuator Line Program:Production:Assembly and Test Cell2
Laser Marking SystemActuator Line Program:Production:Assembly and Test Cell2
17-4PH Stainless Steel Round BarActuator Line Program:Materials and Components1
9310 Alloy Gear Steel BlanksActuator Line Program:Materials and Components1
Aluminum 7075 Housing BilletActuator Line Program:Materials and Components1
NdFeB Rare-Earth MagnetsActuator Line Program:Materials and Components1
Silicon Steel Motor LaminationsActuator Line Program:Materials and Components1
Angular Contact BearingsActuator Line Program:Materials and Components1
Cross Roller Output BearingsActuator Line Program:Materials and Components1
Copper Magnet WireActuator Line Program:Materials and Components1
Harmonic Drive Flexspline BlanksActuator Line Program:Materials and Components1
Harmonic Drive Wave Generator BearingsActuator Line Program:Materials and Components1
Multi-Turn Absolute Encoder DisksActuator Line Program:Materials and Components1
Structural Epoxy Potting CompoundActuator Line Program:Materials and Components1
Thermal Interface GreaseActuator Line Program:Materials and Components1
Actuator Fastener Hardware KitActuator Line Program:Materials and Components1

Definition: reading the Resource type column. The Resource type column takes the same numeric codes Maverick uses internally, rather than the text label shown in the interface: 0 for Human, 1 for Material, 2 for Machine. It is not alphabetical order — Human is licensed headcount and comes first, then the two non-headcount types.

Process tip: this is the only blueprint on this site where import order is the whole trick. Every other CSV or paste-based technique on this site tolerates building resources and tasks in either order, because the tag syntax or the AI prompt sequence handles resource creation inline. A flat CSV import does not — it maps a plain resource name to an existing record. Import Users first, always, whenever the technique is CSV/Excel import.

Station 2: Import the Production Schedule

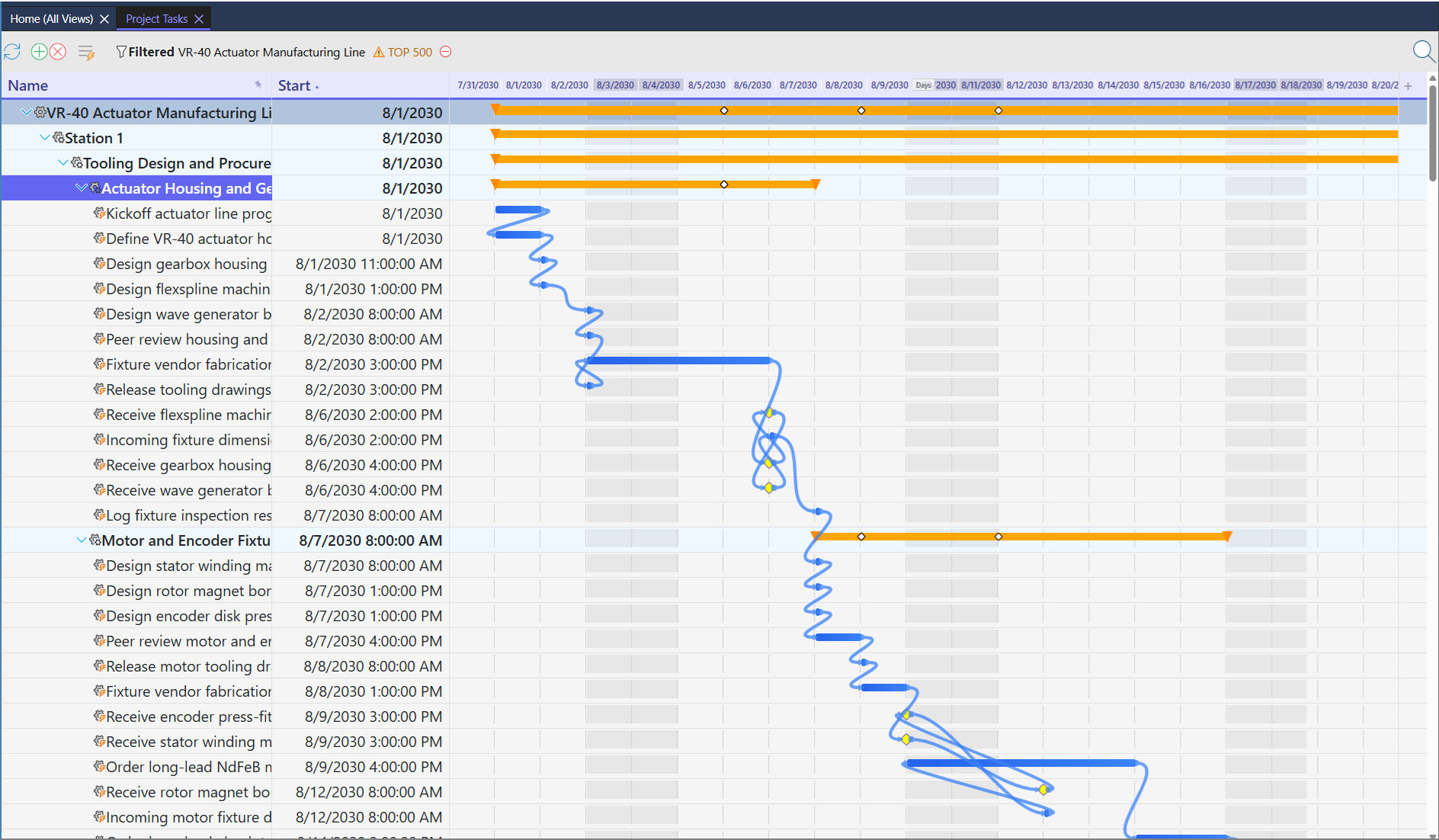

Go to File → Import → Project Tasks and select the tasks CSV below. Unlike every other blueprint on this site, there is no separate project-creation step: the Project column in the first data row reads VR-40 Actuator Manufacturing Line, and because no project with that name exists yet, Maverick creates it automatically as part of the import. The Subproject column then builds the 8-station, 16-subgroup phase hierarchy underneath it, one colon-delimited path per row — the same nesting convention used for workgroup paths in Station 1.

A preview of the file — the full download has all 197 rows across all eight stations:

Station Name Duration Start Predecessors Users
Station 1Kickoff actuator line program charter review2h2030-08-01Program Manager
Station 1Design gearbox housing CNC fixture3d2030-08-02Define VR-40 actuator housing tolerance stack-up[FS]Mechanical Design Engineer
Station 1Fixture vendor fabrication lead time15d2030-08-09Release tooling drawings to fixture vendor[FS]Supply Chain Specialist
Station 25-axis CNC mill IQ/OQ verification1d2030-10-225-axis CNC mill installation and leveling[FS]Manufacturing Engineer, 5-Axis CNC Mill
Station 3Hob flexspline tooth profile3d2030-11-05Rough-turn flexspline blanks[FS]CNC Machinist, CNC Gear Hobbing Machine
Station 3Grind housing seal register to final tolerance1d2030-11-16Drill and tap housing fastener pattern[FS]CNC Machinist, Precision Cylindrical Grinder
Station 4Wind stator coils on automated winding machine2d2030-11-17Actuator housing machining complete[FS]Electromechanical Engineer, Automated Stator Winding Machine
Station 4Mate gearbox subassembly to motor subassembly4h2030-11-17Gearbox component machining complete[FF]; Actuator housing machining complete[FF]Assembly Technician
Station 5Flash bootloader onto actuator controller board2h2030-11-21Encoder and sensor integration complete[SS+3d]Firmware Engineer
Station 5Tune torque-loop PID gains against load cell1d2030-11-24Tune velocity-loop PID gains[FS]Controls Engineer, Torque Test Stand
Station 6Assemble first-article VR-40 actuator unit1d2030-12-05Encoder and sensor integration complete[FS]; Torque control firmware release candidate tagged[FS]; Communication bus and diagnostics bring-up complete[FS]Assembly Technician
Station 672-hour continuous burn-in soak3d2030-12-08Load pilot batch of 10 units onto burn-in rig[FS]Test Technician, Burn-In and Vibration Test Rig
Station 7Rebalance station takt time across the line1d2030-12-24Identify machining cell bottleneck station[FS]Manufacturing Engineer, Production Line Supervisor
Station 7Collect baseline Cpk data on 30-unit sample2d2031-02-07Set Cpk acceptance threshold for flexspline tooth profile[FS]Quality Engineer, Coordinate Measuring Machine (CMM)
Station 8Qualify second-source vendor for NdFeB magnets15d2031-02-13Negotiate volume pricing on 9310 gear steel[FS]Supply Chain Specialist, NdFeB Rare-Earth Magnets
Station 8Produce first steady-state volume batch of 50 units5d2031-03-09Cut over assembly and test cell to volume routing[FS]Assembly Technician, Test Technician
Station 8VR-40 actuator line volume ramp complete0.0h2031-03-17Volume ramp exit review and program handoff[FS]Program Manager

Definition: reading the Predecessors column. Each entry is a task name followed by a link type and optional lag in brackets — TaskName[FS] for a plain Finish-to-Start link, TaskName[SS+3d] for a Start-to-Start link with a 3-day lag. Multiple predecessors on one task are semicolon-separated, as in the subassembly mating step above. Duration follows the same convention used throughout the rest of the site: a number plus h for hours (the default) or d for an 8-hour day, with 0.0h marking a milestone.

Station 3: Verify the Line Structure

Go to Home → Projects, right-click VR-40 Actuator Manufacturing Line, and choose Admin → Subprojects. Eight top-level stations and sixteen nested subgroups should appear in the exact order and nesting from the CSV. Open the project’s task grid and right-click any column header to add Predecessors, Users, and Duration as visible columns if they are not already shown.

Right-click column header menu for adding Predecessors, Users, and Duration columns to the project task grid

Audit note: count before you move on. The task grid should show 197 rows. The Subprojects admin view should show 16 leaf subgroups under 8 station-level parents. If either count is off, the most common cause is a partial import — reopen the CSV and confirm no row was truncated, then re-run the import; Maverick’s importer updates existing tasks by name rather than duplicating them, so a re-import is safe.

Station 4: Confirm the Dependency Cascade

Because the Predecessors column is a first-class field on every task record, the link relationships arrive already wired — unlike the tagged-paste technique used elsewhere on this site, there is no separate manual-linking protocol here. What is worth doing instead is reviewing which links landed where they matter most. Sort the Gantt by start date and look for two things: the Station 4 step that mates the gearbox subassembly to the motor subassembly, and the Station 5 firmware bring-up that starts before hardware integration is finished.

Gantt chart sorted by start date showing dependency link lines across the actuator line schedule FS, SS, FF, and SF link relationship types with lag in Maverick

Look for the one Finish-to-Finish convergence on this schedule. “Mate gearbox subassembly to motor subassembly” carries two Finish-to-Finish predecessors — the last machining task in each of Station 3’s two parallel subgroups. That is the exact moment the mechanical and electromechanical build tracks become one physical part. Two rows later, “Flash bootloader onto actuator controller board” uses a Start-to-Start link with a 3-day lag against Station 4’s completion — firmware bring-up does not wait for hardware to fully finish, it starts three days after hardware integration begins, because a controller board can be flashed and unit-tested on a bench well before the actuator it will eventually control is fully assembled.

Fun Fact: The Gearbox Predates the Robot by 70 Years

The strain wave gearing at the heart of the VR-40 — and at the heart of nearly every actuator in nearly every modern humanoid robot — was not invented for robotics at all. C.W. Musser patented the mechanism in 1955 for aerospace and industrial motion control, decades before a humanoid robot joint needed one. What makes it a fit for robot joints is almost accidental: near-zero backlash and gear reduction ratios of 50:1 to 160:1 in a package a fraction of the size and weight of an equivalent planetary gear train — exactly the torque density a robot joint needs when every gram is fighting the actuator’s own inertia.

Gearbox Type Typical Reduction Ratio Backlash Torque Density
Harmonic drive (strain wave)50:1–160:1Near zero (arc-minutes)High
Planetary gear train3:1–10:1 per stageLow but nonzeroModerate
Cycloidal drive30:1–120:1Near zeroHigh
Spur gear train3:1–6:1 per stageHighestLowest

For more on strain wave gearing and how it compares to other reduction mechanisms, see the strain wave gearing reference on Wikipedia.

Station 5: Assign and Verify Resources

Every task in the CSV already carries its resource assignment from the Users column, so there is no manual assignment step — open the resource pool and confirm the three-type split imported correctly instead.

Resource pool showing human, machine, and material resource types created from the imported CSV files

Then open the resource allocation bar chart to check for over-allocation before setting the baseline.

Resource allocation bar chart showing correct, over-allocated, and under-allocated resources

Warning: the CMM and the torque test stand are single-point bottlenecks by design. This CSV assigns the Coordinate Measuring Machine to dimensional inspection tasks in Stations 1, 2, 3, 6, 7, and 8, and the Torque Test Stand to tasks in Stations 2, 3, 4, 5, and 6. That is not an import mistake — a real pilot line typically has one CMM and one torque stand long before it has a second, because both are capital equipment, not headcount. If the allocation chart shows either one over-allocated, the fix is a schedule shift or a second shift on that station, not adding another named resource that does not exist yet on the shop floor.

Station 6: Set the Baseline

Right-click the project row and choose Advanced → Set baseline for all tasks to lock the plan before the pilot build consumes any tooling or material.

Right-click context menu showing Advanced > Set baseline for all tasks Gantt chart with baseline ghost bars below each task bar

Look for the difference between a tooling ghost bar and a procurement ghost bar. The fixture vendor lead time in Station 1 carries a 15-day ghost bar that is fully within Maverick’s control to renegotiate. The NdFeB magnet second-source qualification in Station 8 carries a 15-day ghost bar too — but rare-earth magnet supply is a global, not a vendor-specific, constraint. When either bar drifts later, the response is different: call the fixture shop for one, start a second supplier conversation months earlier next time for the other.

Station 7: Run the Critical Path

Right-click the project row and choose Advanced → Recalculate critical path. Critical tasks appear in red.

Right-click context menu showing Advanced > Recalculate critical path option

Gantt chart with critical path tasks highlighted in red and dependency link lines visible

Industry insight: the critical path runs through a quality gate, not a lathe. Machining is the most visually dense part of this schedule — Stations 2 and 3 have more tasks and more machine resources than any other station — but zero float ends up concentrated at the Station 6 first article inspection gate and the Station 8 long-lead magnet second-sourcing task. On a mature production line, cutting metal is rarely what determines the finish date; the gate that decides whether metal that has already been cut is good enough to ship usually is. That is the single biggest lesson this blueprint teaches about ramp scheduling specifically: machining capacity is scalable with a second shift, but a quality gate and a global material constraint are not.

Station 8: Explore the Resource-Centric Gantt

Switch to the resource-centric Gantt to see all three resource types laid out across the full 33-week program.

Resource-centric Gantt view showing tasks assigned to each resource across the actuator line program

What to look for in the resource Gantt. Material rows — the gear steel, the housing billet, the magnets — should show two distinct clusters: a light one at the Station 1–3 pilot quantities, and a much heavier one at the Station 8 volume-ramp purchase orders. Machine rows should show near-continuous use through Stations 2 and 3, then thin out as work shifts to assembly, controls, and quality in Stations 4 through 6. Human rows tell the ramp story most clearly: the CNC Machinist and Assembly Technician rows should visibly step up in density at Station 7, where second-shift hiring and cross-training land — the schedule's clearest signal that this is a line being built to scale, not a single unit being finished.

Related Topics

For a full explanation of Gantt chart task bars, link lines, and the baseline ghost bars used in Stations 4 and 6, see Gantt Charts in Project Management. For the four link relationship types used in the Predecessors column, see Task Link Relationships Explained. For how Maverick calculates zero-float tasks, see Critical Path Method. For the full workflow of setting, clearing, and restoring baselines, see Project Baselines: Set, Clear, and Restore. For how to read the resource allocation bar chart and resolve the kind of shared-machine bottleneck described in Station 5, see Resource Allocation Bar Chart. To see the same kind of schedule built by pasting a single tagged text block instead, follow the CRISPR-Cas9 Gene Therapy R&D Program blueprint; to see one built entirely by AI prompts, follow the Battery Energy Storage System blueprint.
